Power poles · The Energex process

How your pole gets connected to power

We install the pole and lodge the Energex paperwork. Energex connects it to the street. Your retailer fits the meter, and that's when the power comes on. Here's each step, who does it and how long it usually takes.

Energex paperwork
We lodge it for you
Energex connection
Usually 2–4 weeks6–8 weeks with traffic control
Power on
When the meter is fitted

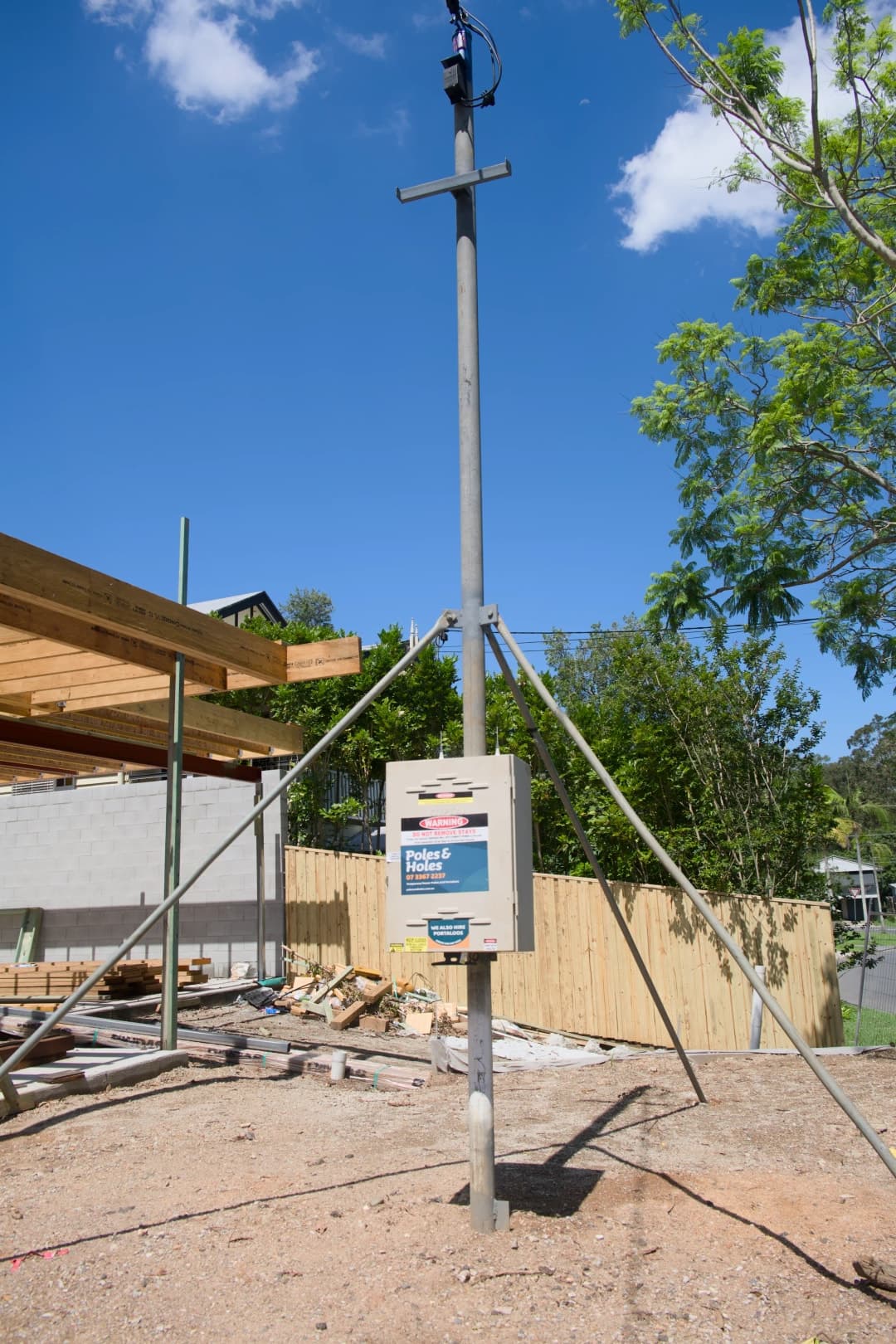

Temporary builder's power pole with metal stays on a Brisbane site
01 · The short answer

Energex connects your pole. Your retailer turns the power on.

Mixing those two up is behind most “why is there no power?” calls. A pole can be standing and connected to the street with no power at all, because the meter isn't in yet.

Stage 1

We've installed and lodged

  • Pole installed on site(done)
  • Energex paperwork lodged(done)
  • Connected to the street(not yet)
  • Meter fitted(not yet)
No power

Waiting on Energex to connect the pole: usually 2–4 weeks, or 6–8 weeks with traffic control.

Stage 2

Energex has been

  • Pole installed on site(done)
  • Energex paperwork lodged(done)
  • Connected to the street(done)
  • Meter fitted(not yet)
Still no power

Connected, but not live. The meter isn't in yet. This is where most calls come from.

Stage 3

The meter is fitted

  • Pole installed on site(done)
  • Energex paperwork lodged(done)
  • Connected to the street(done)
  • Meter fitted(done)
Power on

Your retailer's meter installer has been. Plug in and start work.

02 · Step by step

From quote to power on

Who does each step, and how long it usually takes. Timings are typical, not promises: Energex and your retailer set their own schedules.

Builder's site, 3-phase and underground. 6 steps.

  1. Step 01You

    Ask for a quote

    Tell us the address, the date you need power, and whether the street supply is overhead or underground.

    Book 4+ weeks ahead

    Same day: open an account with your electricity retailer.

  2. Step 02Poles and Holes

    We deliver and install the pole

    The pole is built and certified at our depot and installed by our crew. Visits by our electricians for Energex connection work are charged to you; we confirm the required work in your quote.

    Date confirmed with your quote
  3. Step 03Poles and Holes

    We lodge the Energex paperwork

    We arrange the Connect Application and the EWR (Electrical Work Request) at their required stages. The application and accepted connection offer come before the EWR confirms the electrical installation is ready. We email you the EWR number once lodged.

    Included in your hire
  4. Step 04You

    Call your retailer with the EWR number

    Your retailer uses it to book the Energex connection and the meter install.

    As soon as we email it
  5. Step 05Energex

    Energex connects the pole to the street

    Energex runs the service line from the street to your pole. Connected doesn't mean live: the meter still has to go in.

    Usually 2–4 weeks

    6–8 weeks if your site needs traffic control, usually on a busy road.

  6. Step 06Your retailer

    Your retailer fits the meter. Power on.

    Their meter installer fits the meter. That's when the pole goes live and you can plug in.

    Usually a few days after Energex
Your part

Two calls to your electricity retailer

  1. The day you book:open an account. Ask for a temporary builder's supply at the site address. Choose a retailer that offers the required builder’s supply.
  2. When we email the EWR number:call them with it. That's what lets them book Energex and the meter.

Tell us which retailer you chose so the paperwork matches your account. Tip: ask what each retailer charges to set up a builder's supply. Confirm their account and metering charges.

03 · Who does what

Three organisations, one order

Each one does its part and hands over to the next. Knowing who does what tells you who to call.

Us

Poles and Holes

Our licensed electricians build and certify the pole at our depot. Our crew delivers and installs it. We lodge the Energex paperwork and email you the EWR number.

Call them about

Your quote, install date, the EWR number and collection.

(07) 3367 2237
The network

Energex

Runs the electricity network in South East Queensland. Connects your pole to the street mains.

Call them about

Connection timing, once your retailer has booked it.

13 12 53
Your account

Your electricity retailer

Holds your account. Books the Energex connection and the meter install, then bills your usage.

Call them about

Opening the account, the EWR number, the meter booking and your bills.

Your part

You

  • Open a retailer account the day you book.
  • Pass the EWR number to your retailer.
  • Keep the path to the meter box clear.
  • Call us to off-hire once the wiring is disconnected.

Replacing a permanent pole? Your own licensed electrician also makes the connection from the pole to your switchboard and certifies that work. They bill you for it directly.

04 · Your street supply

Where your power comes from changes the connection

Tell us which one you have when you ask for a quote. If there's a green Energex pillar near your front boundary, it's underground.

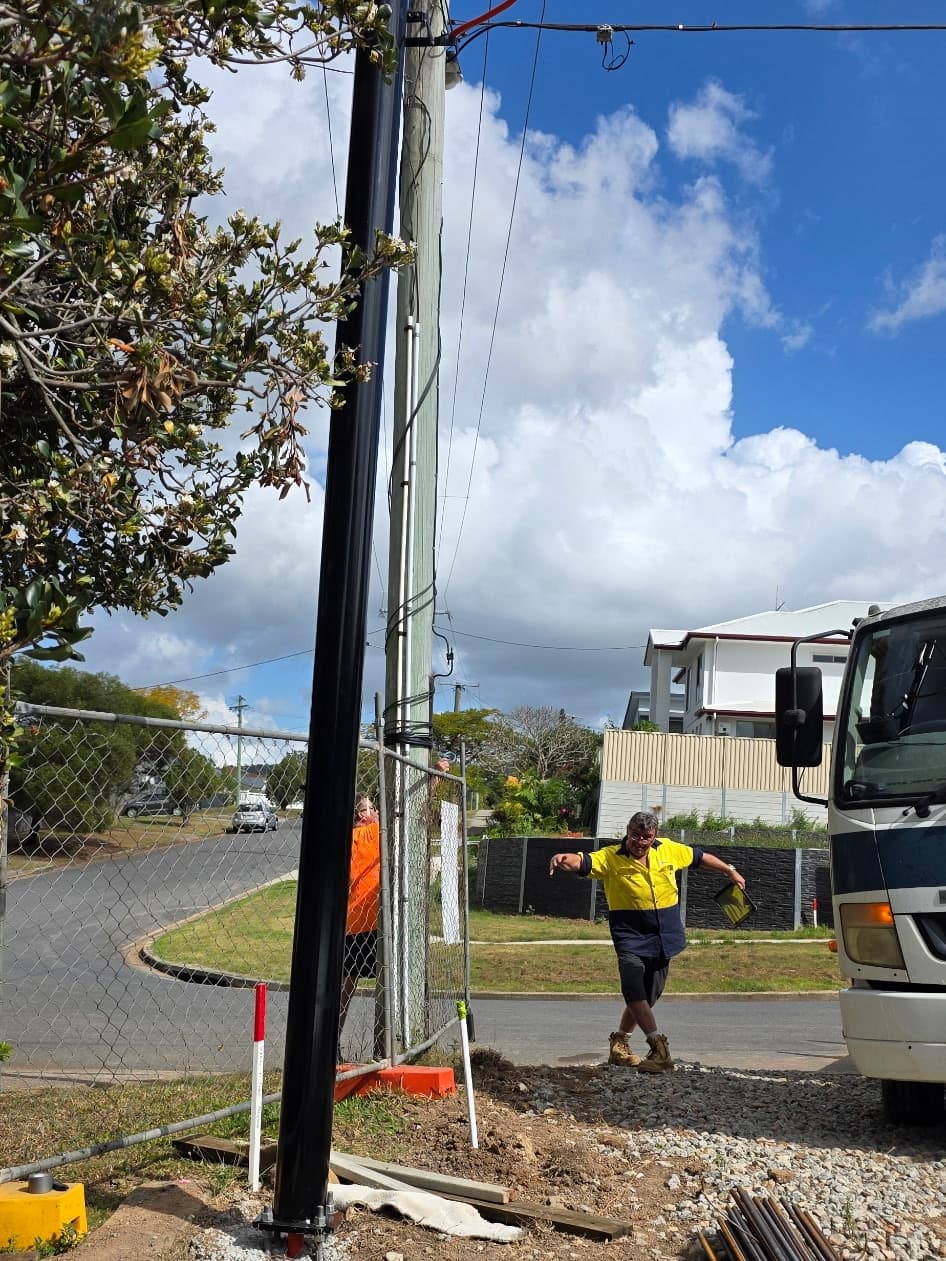

Service line running from the street to a power pole on site
Most established streets

Overhead

Energex runs a service line from the street pole across to yours. This is the standard builder's site pole, and the steps above are exactly how it goes.

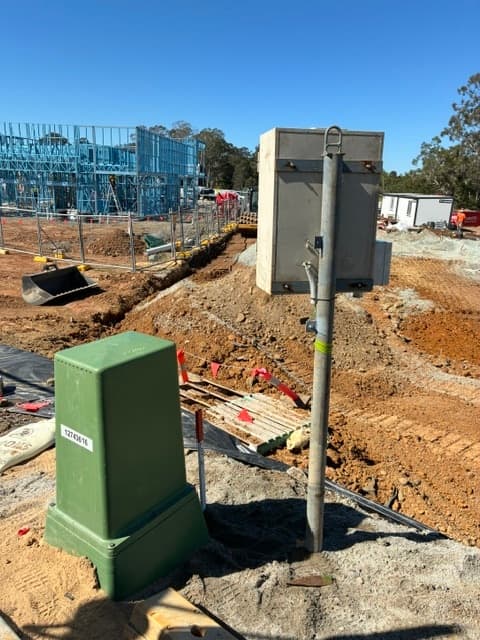

Underground temporary power connection: an Energex pillar and conduit in the trench beside the pole
Newer estates

Underground

The pole connects into the green Energex pillar on your lot. We send our own licensed electrician to check the pillar is set up for our pole and make the connections good, then Energex connects it.

Same hire rate as an overhead pole. The electrician's visit is invoiced separately.

05 · Delays

What slows a connection down

Knowing about these early is usually enough to avoid them.

No retailer account

Your retailer can't book Energex or the meter until an account exists and has the EWR number.

A busy road

Traffic control is free, but arranging it can extend the network connection estimate to 6–8 weeks.

A blocked meter box

Keep the path clear. The energy company may charge for a wasted trip.

Scaffold near the pole

Scaffolding near electrical lines needs a site-specific clearance assessment. Check Energex Safety Advice before planning the work; a pole working-space guide is not an electrical exclusion distance.

Wet weather

Rain can stop trucks getting on site and push the install date back.

06 · End of the build

When the build is finished

The pole has to be disconnected before it can leave, and that's arranged through your retailer, not us. The order matters here too.

  1. 01 · You

    Close the temporary account

    Once permanent power is on, call your retailer to close it. If the wires aren't moving to a permanent supply, ask them for a Supply Abolishment.

  2. 02 · Through your retailer

    The wiring is disconnected

    The service line and meter come off the pole. We can't take a pole away while it's still wired.

  3. 03 · Us

    Call us to off-hire

    Call or email once it's disconnected and we'll book the collection.

07 · Questions

Common questions

Want the paperwork in more detail? Read our Energex temporary power connection guide.

How long does Energex take to connect a temporary pole?

Usually 2–4 weeks from when the EWR goes in. If your site needs traffic control, usually because it's on a busy road, allow 6–8 weeks. These are typical network estimates, not a guaranteed power-on date; retailer metering also needs to be completed. Traffic control is free.

Energex has been. Why is there still no power?

Energex connects the pole to the street, but the pole isn't live until your retailer's meter installer fits the meter. If you haven't heard about a meter booking, call your retailer and check they have the EWR number we emailed you. They can't book the meter without an account in your name.

How far ahead should I book?

At least four weeks before you need power, or eight if your site needs traffic control. Energex's 2–4 weeks connection is the long part, and its clock only starts once the paperwork is lodged.

Can the paperwork start before the pole goes in?

The connection application can start during planning. An EWR is different: it confirms the relevant electrical work is ready. We coordinate each document at the appropriate stage and send you the EWR reference after lodgement.

Do I need my own electrician?

Our electricians carry out the required connection work for temporary poles, and their visits are charged to you. For permanent poles, your own licensed electrician handles the work from the pole to your building. We confirm the responsibilities and charges in your quote.

Can you speed Energex up?

No. Energex schedules its own crews. What does save time is booking early, so the paperwork goes in sooner, and passing the EWR number to your retailer the day we send it.

What do Energex and my retailer charge?

Standard Energex fees are not included in permanent meter-box and connection packages. Visits by our electricians for connection work are charged to you. Your retailer and metering provider confirm their own account and metering charges. Traffic control is free, but it extends connection timing.

08 · Get started
We do the paperwork

Book at least four weeks before you need power.

Energex usually takes 2–4 weeks to connect, or 6–8 weeks with traffic control. We install the pole and lodge the paperwork. You open the retailer account and pass on the EWR number.
